Basement Finishing Cost in Baltimore: 2026 Pricing Guide

Basement Finishing Cost in Baltimore: 2026 Pricing Guide

If you own a Baltimore rowhome and you are trying to figure out what it actually costs to finish your basement in 2026, here is the honest version: all-in for an underpinned, finished basement with one room plus a bath, you are looking at $45,000 to $65,000. That is the real Baltimore number. Not the national average. Not a retail estimator. What it costs to do it here without cutting corners.

If your basement already has 7 feet of headroom and a dry floor, you skip the underpinning and the all-in drops fast, usually $25K–$40K for a finished room, bath, and egress. If you are starting with 5’8” of headroom and a dirt floor with a sump, you are dig-down territory and the number lives in the $45K–$65K range or higher.

This guide breaks down every line item, what drives the number up and down, and what most Baltimore homeowners actually spend on basement finishing in 2026.

Average Basement Finishing Costs in Baltimore (2026)

Baltimore basements are not like basements in newer suburban construction. The classic rowhome basement is 6 feet of headroom, dirt floor, a sump, and a stone-and-mortar foundation that has been there since 1920. Finishing it requires more than drywall and paint.

Here is how the costs break down by scope.

Scope 1: Cosmetic Finish (Existing 7’+ Headroom): $15,000 – $25,000

If you already have 7 feet of headroom, a dry concrete floor, and no moisture problems, you can finish the room out without major structural work. Typical scope:

  • Framing perimeter walls and any interior partitions
  • Insulation (vapor barrier, batt or foam)
  • Drywall, mud, sand, paint
  • LVP flooring or carpet over subfloor
  • Recessed lighting, outlets, switches
  • Trim, baseboard, doors
  • Egress if a bedroom is included (code-required)

This is the cheap path. It works for the minority of Baltimore rowhomes with usable headroom, but most do not have it.

Scope 2: Underpinning + Finished Room + Bath (Most Common): $45,000 – $65,000

This is the MBR sweet spot and the scope most Baltimore rowhome owners actually need. Here is what is in the number:

  • Underpinning to roughly 7 feet of finished ceiling height, $20K–$30K
  • Finished room (framed, insulated, drywalled, floored, painted), $8K–$12K
  • Full basement bathroom (tiled, fixtured, ejector pump), ~$15K
  • Egress window cut and installed where code requires, ~$5K
  • Waterproofing and drainage as part of the underpin
  • Permits and inspections

We have to underpin most Baltimore rowhomes because the original foundation was poured shallow. Underpinning is the process of digging down beside the existing foundation in sections, pouring new concrete underneath, and then excavating the basement floor down to the new level. It is slow, dirty, and the single biggest line item.

If you skip the bath, drop $15K. If you skip the egress, drop $5K. If you have an existing exterior basement entrance and don’t need a new egress cut, drop the $5K.

Scope 3: Full Basement Apartment / Rental Unit: $70,000 – $110,000+

If you are converting your basement to a legal rental unit (we have a full guide on whether you can convert a Baltimore basement to a rental), the scope jumps significantly. You need:

  • Underpinning to full code headroom (often 7’6”+)
  • Separate entrance (existing exterior or new bilco/walk-up cut)
  • Full kitchen or kitchenette
  • Full bathroom
  • Sleeping area with egress window
  • Separate HVAC zone or dedicated mini-split
  • Sound-attenuated ceiling between units
  • Separate electrical sub-panel (sometimes)
  • Zoning approval and proper permits

These are 4 to 6 month projects and they often involve coordination with Baltimore City zoning. Numbers above $110K are not unusual on these.

What Drives Basement Finishing Costs in Baltimore

Five things move the number more than anything else: headroom, moisture, the foundation, the plumbing situation, and whether you need an egress cut.

Underpinning: $20,000 – $30,000 (When You Need It)

This is the biggest single variable. If your existing headroom is under 6’8”, you almost certainly need to underpin to get to a usable finished height. The cost depends on the length of foundation we are excavating, the soil conditions, and whether we hit anything unexpected (old footings, buried utilities, water).

Underpinning is not optional if you want a code-compliant finished basement with reasonable headroom. You can sometimes get a permit for a “low-headroom finish” but it kills the resale story and most homeowners regret it.

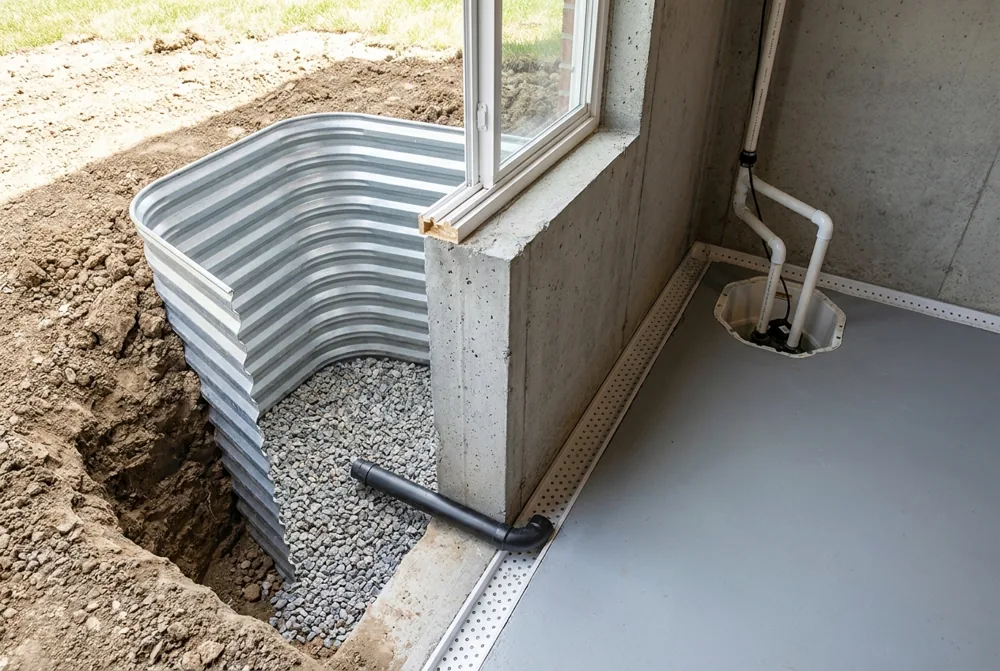

Egress Windows: $4,000 – $6,000 Each

If your finished basement includes a bedroom, or sometimes any habitable room, Baltimore code requires an egress window. That means cutting through the foundation wall, installing a window well, and setting a fire-rated window. Cost varies based on whether you are cutting through stone-and-mortar foundation (slower) or poured concrete (faster).

Basement Bathroom: ~$15,000

A basement bath is almost always more expensive than an upstairs bath because the drain has to go up, not down. That means an ejector pump, which adds $1,500–$2,500 to the plumbing line. Otherwise the scope is similar to a mid-level full bath upstairs, tile, vanity, toilet, shower, GFCI, exhaust, drywall, paint.

Waterproofing and Drainage

This is non-negotiable in Baltimore. If your basement is actively wet, we will not finish it until the water problem is fixed. Interior French drain plus sump pump runs $4K–$8K. Exterior waterproofing is more expensive but more durable. We discuss the options on the first visit and price them in.

Baltimore-Specific Cost Factors

  • Stone foundations, common in pre-1920 rowhomes; harder to underpin than poured concrete
  • Shared party walls, underpinning a rowhome means coordinating with neighbors and being careful not to undermine the adjacent unit
  • Tight access, most Baltimore basements have one narrow stair down and no exterior entrance; getting equipment and material in/out adds labor time
  • Old plumbing stacks, cast-iron drain stacks often need partial replacement once we are working at the basement level
  • Permits, Baltimore City requires permits for underpinning, structural, plumbing, electrical, and egress; we pull and manage all of them

What’s Included in Our Standard Basement Quote

A typical underpinned-finished-with-bath estimate from MBR includes:

  • Underpinning (sectional, to ~7’ headroom)
  • New concrete floor slab with vapor barrier
  • Interior drainage and sump (if needed)
  • Framing all walls, soffits, ceiling chases
  • Insulation (rigid foam on foundation walls, batt on partitions)
  • Drywall, mud, sand, paint
  • Flooring (LVP standard, carpet on request)
  • Egress window cut and install (where required)
  • Full basement bath (tile, fixtures, ejector pump)
  • Electrical (outlets, lighting, sub-panel if needed)
  • HVAC tie-in or dedicated mini-split
  • Trim, baseboard, doors
  • Permits and all inspections

Basement Finishing Timeline

A standard underpin-plus-finish-plus-bath project runs 4 to 7 weeks at MBR. Underpinning alone takes 2–3 weeks because it is done in sections. The finish-out phase adds another 2–4 weeks. Egress cut adds 2–3 days. Permits typically add 1–2 weeks on the front end before we can swing a hammer.

Full basement apartments run 4 to 6 months including zoning review.

Our Basement Finishing Process

  1. Walkthrough and headroom measurement, we measure floor-to-joist before quoting because it drives everything
  2. Moisture and foundation assessment, we check the sump, the foundation walls, the stack, and any visible water issues
  3. Written estimate, line-item breakdown within 48 hours, with options for skipping the bath or egress if budget is tight
  4. Permits, we pull underpinning, structural, plumbing, electrical, and egress permits
  5. Build, underpinning first, then floor pour, then framing, then mechanicals, then finishes
  6. Final inspection and walkthrough, city signs off, you sign off, you get care instructions

Get Your Free Basement Finishing Estimate

Ready for real numbers on your Baltimore basement? Every basement is different, your number depends on existing headroom, moisture conditions, and scope. We come measure before we quote.

Request your free estimate or call (443) 602-9300. Licensed Maryland contractor (MHIC #149066), Google Guaranteed, EPA Lead-Safe certified.

For more on what we do, see our basement finishing service page.

Common Questions

How much does it cost to finish a basement in Baltimore in 2026?
Basement finishing in Baltimore costs between $15,000 and $110,000+ in 2026 depending on scope. The most common scenario, underpinning to get usable headroom, plus one finished room, plus a full basement bathroom, plus an egress window, runs $45,000 to $65,000 all-in. If you already have 7+ feet of headroom and just need to finish the space, expect $15,000 to $25,000. A full basement apartment with kitchen and separate entrance can run $70,000 to $110,000 or more.
Do I need to underpin my Baltimore basement?
Most Baltimore rowhomes built before 1950 have basement headroom of 5'8" to 6'6", which is below the code minimum for habitable space. Underpinning, digging down beside the foundation in sections and pouring new concrete underneath, is the standard way to get to 7 feet of finished ceiling height. Underpinning typically costs $20,000 to $30,000 depending on the length of foundation and soil conditions. If you already have 7+ feet, you can skip it.
How long does basement finishing take in Baltimore?
A standard underpin-plus-finished-room-plus-bath project takes 4 to 7 weeks of active construction, plus 1–2 weeks of permit time on the front end. Underpinning takes 2–3 weeks on its own because it is done in sections. Full basement apartment conversions run 4 to 6 months including zoning review.
Do I need a permit to finish my basement in Baltimore?
Yes. Baltimore City requires permits for underpinning, structural work, plumbing, electrical, and egress windows, which covers nearly every basement finishing project. Permit fees typically range from $500 to $1,500 depending on scope. At Monarch Bay Renovations, we pull and manage all permits, including any zoning approval required for legal rental units.
What if my basement is actively wet?
We will not finish a basement that has active moisture problems, it will fail. We address the water first: French drain and sump for interior drainage ($4,000–$8,000), exterior waterproofing if the problem is exterior infiltration, or grading changes outside the foundation. Once the basement is dry and stays dry through a wet season, we can finish it. The fix is part of the estimate when we walk the space.
